AI Case Study 5

Construction Strategy

ai tools

Claude

task

Phasing, Schedule, Cost Estimation

and Risk Mapping

project

THE SHARDS

project type

Recreational Facility / Pavilion

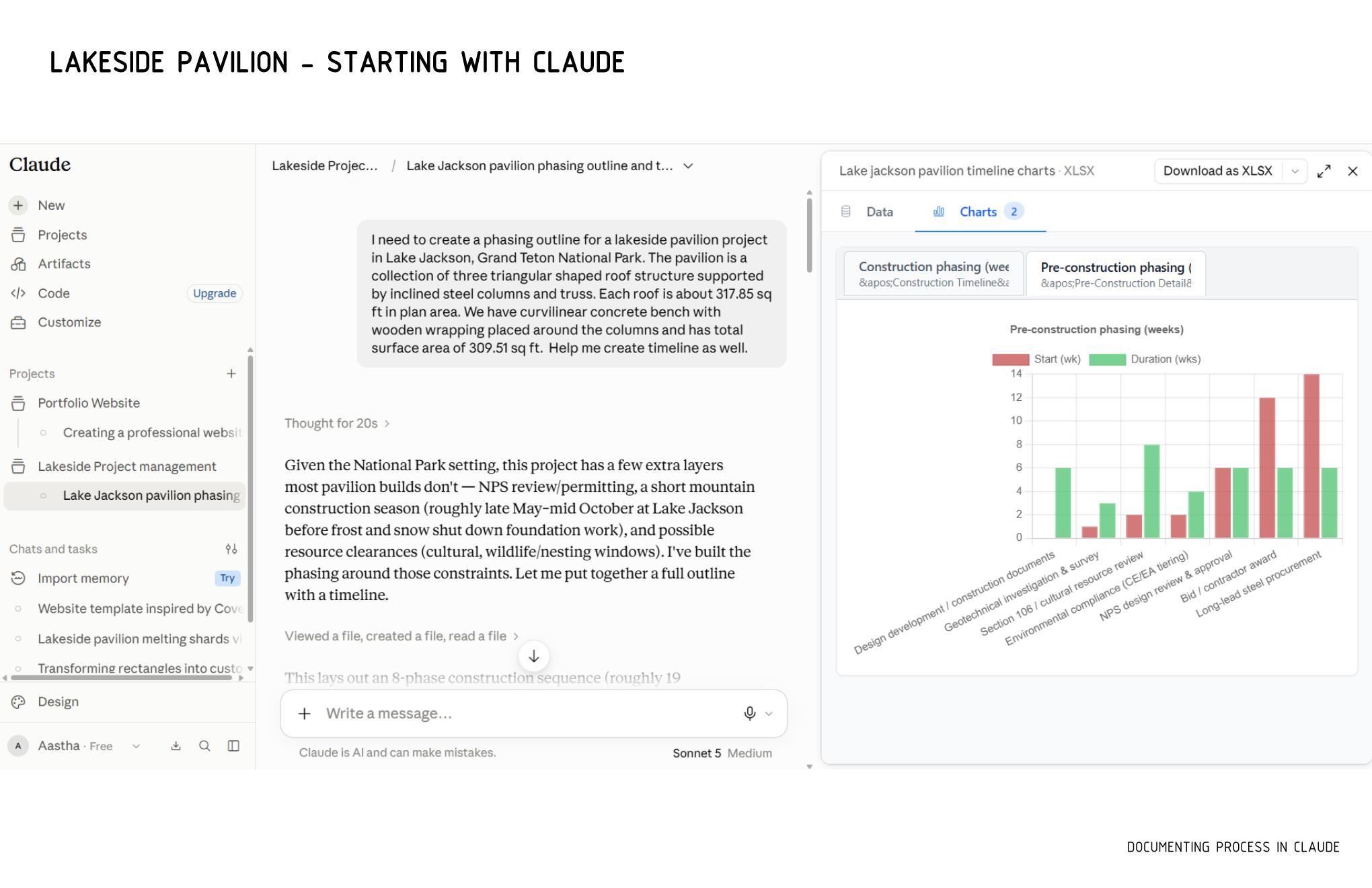

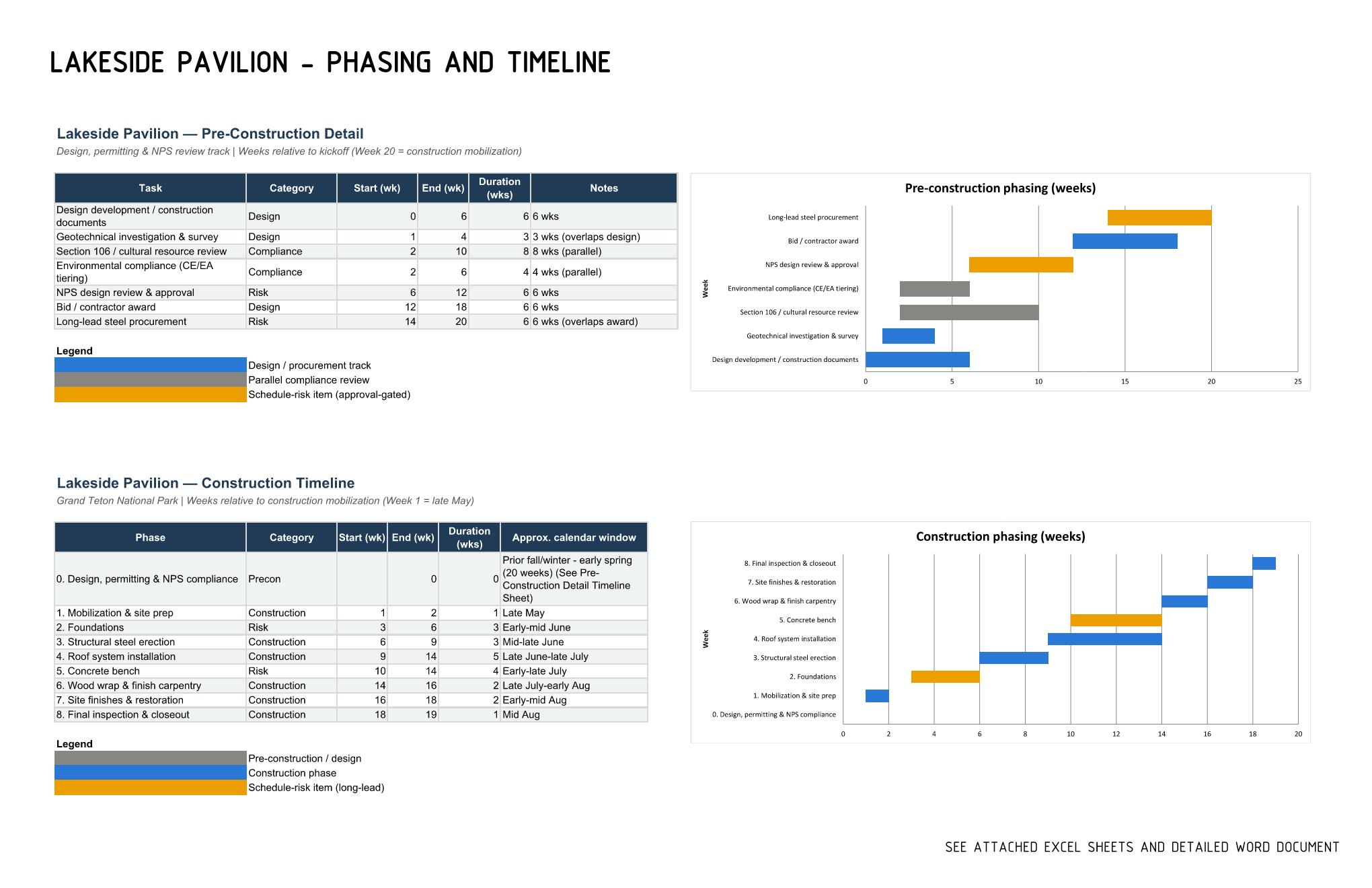

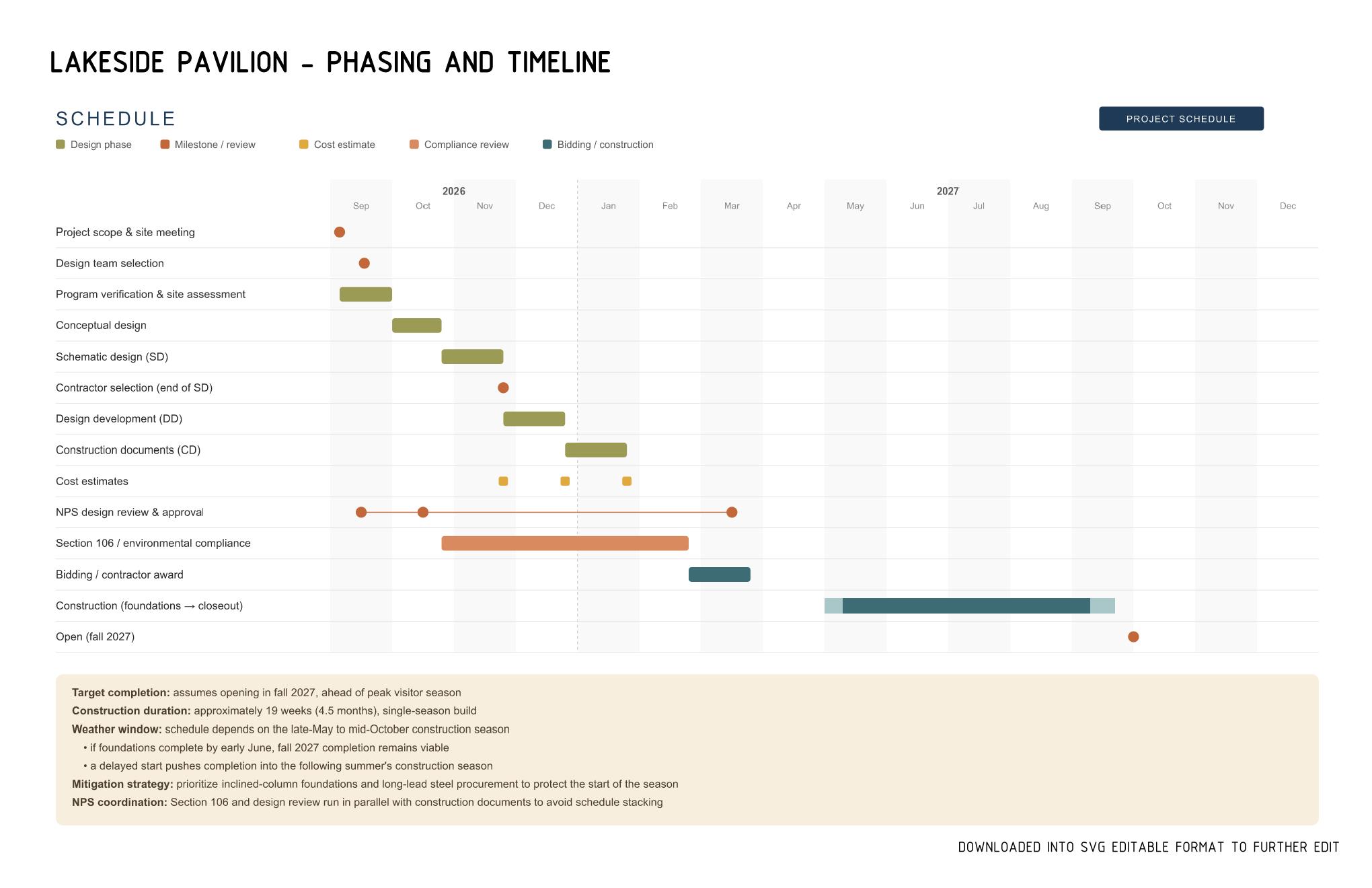

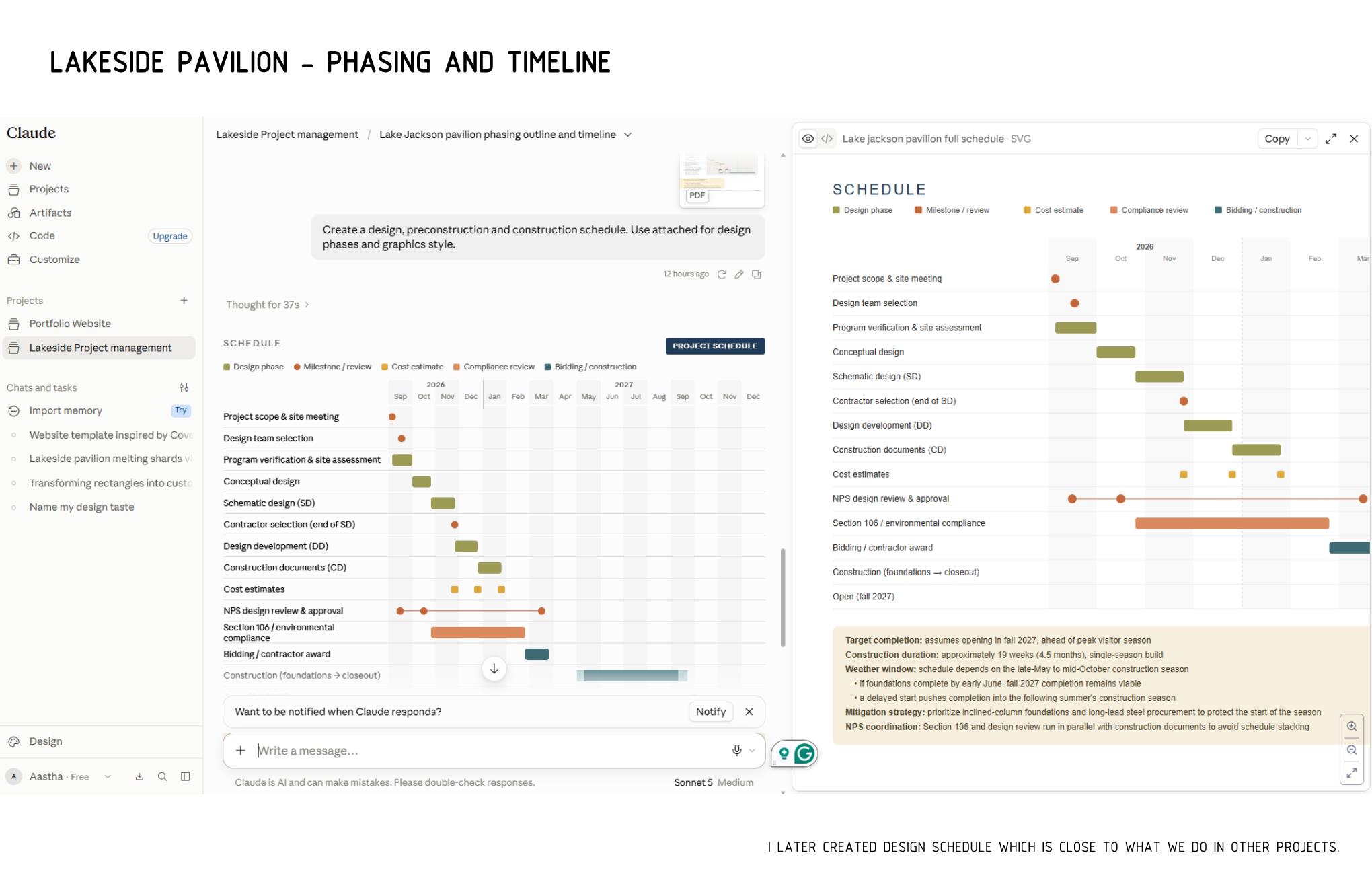

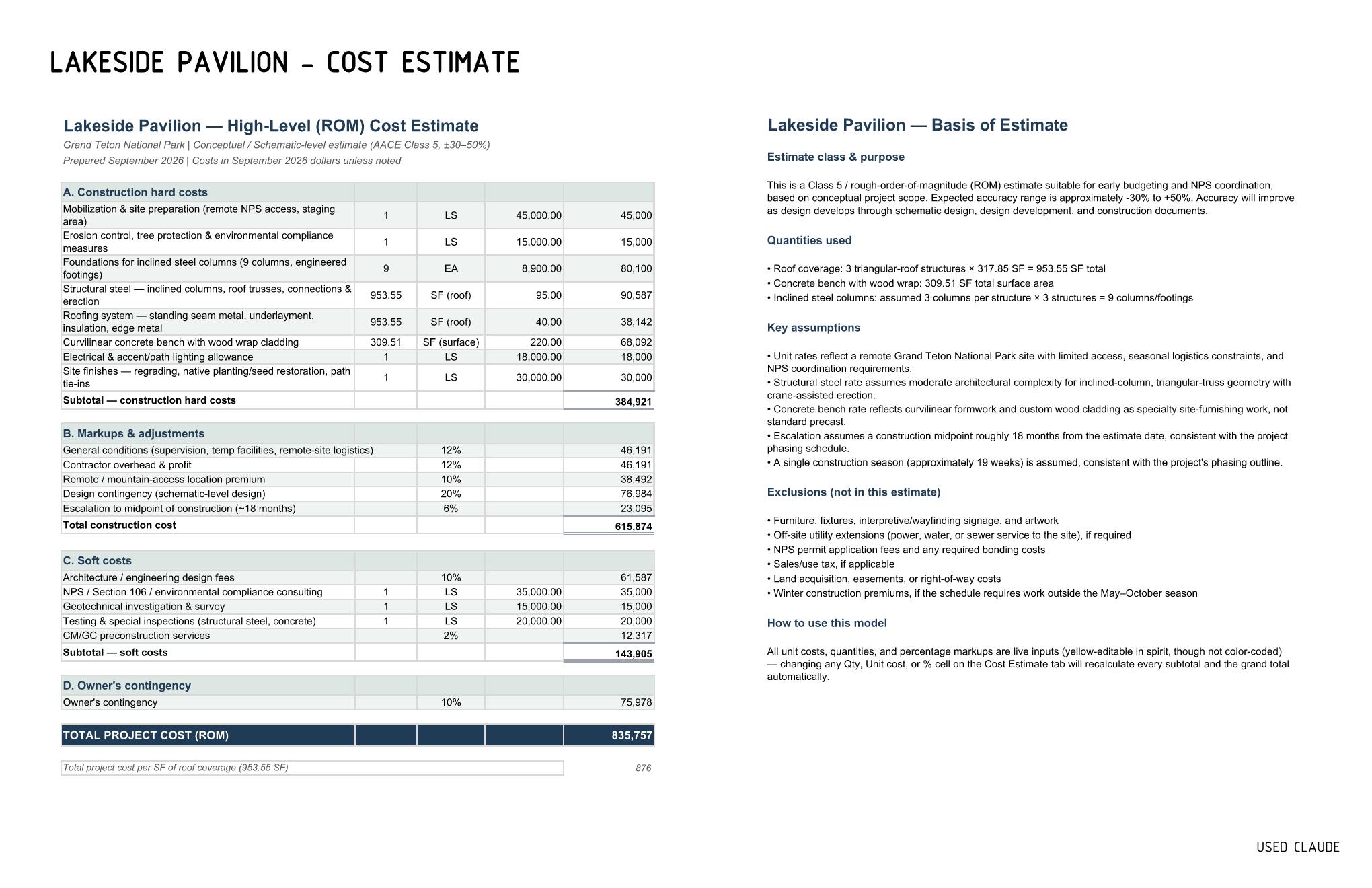

I started with a prompt that best described the project focusing on the construction materials and site context. Then I got several iterations and corrections and downloaded the graphics and data in an editable format. I used a graphic template based on a similar project to get the design schedule format I use on daily basis. Cost estimation and risk log were also generated and helped me understand the construction side of the project. This was a little bit more about gaining knowledge on construction strategies vs. developing at the current early stage of my career.
